Three Gorges Zhangpu Phase II offshore wind power project bid opening
Seetao 2023-01-10 15:02
  • The site area of the project is about 22.9 square kilometers, and the total installed capacity of the project is 400MW
  • This project is the first offshore wind power project in southern Fujian and the first wind farm of the Three Gorges Group in the southern Fujian shoal
Reading this article requires
6 Minute

At the beginning of the new year, China Railway Bridge Bureau grabbed the golden period of operation, and as a member of the consortium, won the bid for the Three Gorges Zhangpu Phase II offshore wind power project, with a winning amount of 3.057 billion, achieving a good start in 2023.

Three Gorges Zhangpu Phase II offshore wind power project

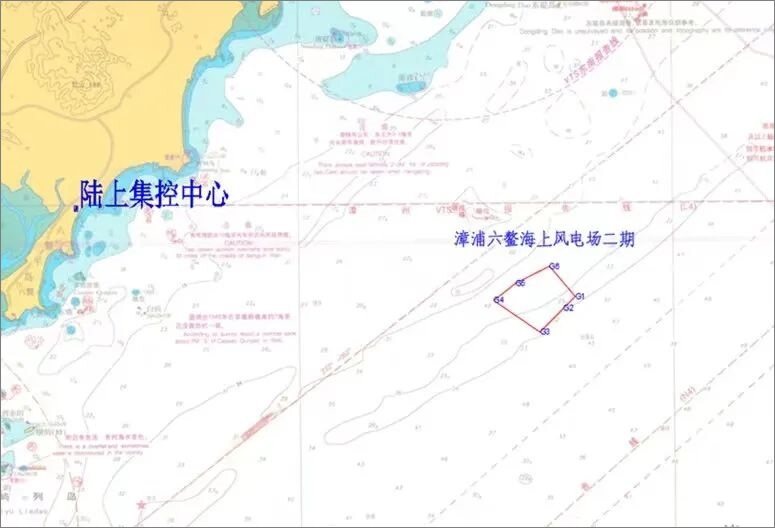

The planned site of the winning project is located in the offshore sea area on the southeast side of the Liu'ao Peninsula in Zhangpu, with an area of about 22.9 square kilometers. The site is 30.3 to 36.7 kilometers away from the Liu'ao shoreline in the west, 32.8 kilometers away from the shoreline in the center, and the theoretical water depth is 26 to 40 meters. The total installed capacity of the project is 400 MW. The planned unit capacity is 8 sets of 13 MW, 13 sets of 14.3 MW, and 7 sets of 16 MW+wind turbines. The hub center height is 150 meters. A 220kV sea booster station will be built. After the wind turbine units are boosted by the unit booster transformer, they will be connected to the 220kV sea booster station through 35kV submarine cable. After the voltage is boosted to 220kV through the sea booster station, they will be sent out and connected to the onshore centralized control center under construction through two 220kV AC submarine cables. The onshore centralized control center will be connected to the power grid through overhead lines.

The project plans to complete the grid connection of the first batch of units by the end of August 2023, complete all foundation construction and submarine cable laying by the end of December 2023, complete the grid connection of 23 wind turbines, complete the grid connection of all units by the end of October 2024, and complete the completion acceptance by the end of June 2025.

It is reported that this project is the first offshore wind power project in southern Fujian, and the first wind farm of the Three Gorges Group in the southern Fujian shoal. In the future, Fujian Province will build a demonstration base of 10 million kilowatts of offshore wind power in this region. Key words: engineering news, new energy engineering

This project is not only another offshore wind power project developed by China Railway Bridge Bureau in Fujian market after Fuqing Xinghua Bay, Changle Outer Sea Area A, Pingtan Highway and Railway Lighting and Pingtan Outer Sea Wind Power Project, but also opens another field for offshore wind power construction in Fujian Minnan Shoal, winning the first opportunity for offshore wind power regional development and base construction. Editor/Zhao E


Comment

Related articles

Central enterprises

The 12th Hydropower Bureau and the Zhejiang Emergency Department build a rescue alliance

08-19

Central enterprises

XCMG Group and Rio Tinto Group sign a global cooperation framework agreement

08-15

Central enterprises

China Power Construction and State power Investment leaders to deepen energy cooperation

07-20

Central enterprises

China Construction Third Engineering Bureau Zhejiang Transportation Project

07-18

Central enterprises

5.635 billion yuan! China Energy Construction won the bid for Jinneng Phase III project

07-15

Central enterprises

National Railway Administration and Chongqing City Sign Cooperation Agreement

07-04

Collect
Comment
Share

Retrieve password

Get verification code
Sure
